The Great Transmission Delusion: Why Credit Rating Methodologies Missed India’s Systemic Grid Bottleneck

The Great Transmission Delusion: Why Credit Rating Methodologies Missed India’s Systemic Grid Bottleneck - Featured Cover Image

When rating agencies like ICRA published their mid-2026 updates exposing severe transmission bottlenecks across India’s clean energy belts, financial markets panicked. Domestic commentators quickly painted grid congestion as an unexpected, suddenly materialising operational headache.

It was nothing of the sort.

Examine the hard construction figures and a starkly different reality emerges. The structural rupture between green power capacity additions and high-voltage line construction has been widening since 2022–23. Physical cable laying repeatedly missed statutory goals, yet credit rating algorithms rested easy behind backward-looking debt service coverage metrics. Now, with a mere eight months left in the 14th National Electricity Plan (NEP 2022–27) cycle, flagging these infrastructure deficits is not an insightful forecast. It is a post-mortem.

Utility-scale solar installations have surged ahead—hitting 84% of their overall NEP 2022–27 capacity target. Meanwhile, the physical wire network meant to evacuate those electrons has ground to a halt.

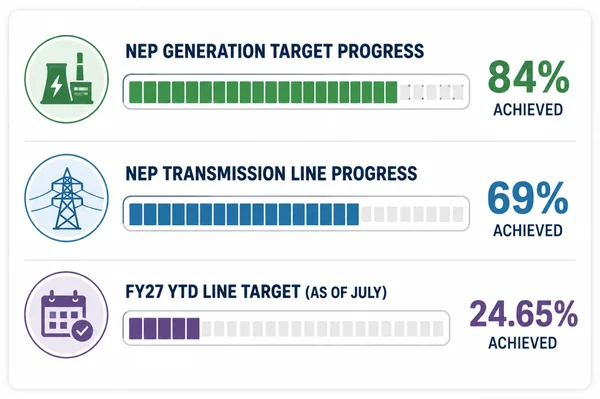

At a Glance: Systemic Grid Constraints in August 2026

The Great Transmission Delusion: Why Credit Rating Methodologies Missed India’s Systemic Grid Bottleneck - Graphic Illustration 1
  • Methodological Blindspot: Credit rating agencies correctly evaluated project-level debt structures backed by SECI payment security, but failed to price in system-level curtailment and connection bottleneck risks now materializing across Rajasthan and Gujarat.
  • Target Re-baselining: In FY26, physical execution (12,139 ckm) appeared respectable against a mid-year downgraded target of 15,382 ckm (78.92%), but represented under 50% execution when measured against the original NEP-aligned requirement of 24,400 ckm.
  • An Impossible Run-Rate: To hit the remaining FY27 line targets, India must now construct over 1,550 circuit-kilometers (ckm) per month through March 2027—nearly double its best historical monthly execution rate.

Goalpost Re-baselining and Structural Realities (2025–26)

Understanding how India’s transmission deficit stayed hidden inside institutional capital markets requires unpicking the quiet bureaucratic target shifts of the last two fiscal cycles.

In 2024–25 (FY25), real grid construction tanked. Against an unambitious goal of 15,253 circuit kilometres (ckm), contractors completed just 8,830 ckm—a dismal 57.89% achievement rate. The drag was brutal: relentless litigation over Right-of-Way (RoW) land claims, stalled forest clearances across sensitive ecological corridors, and administrative friction in awarding Tariff-Based Competitive Bidding (TBCB) contracts.

Did official frameworks accelerate building in 2025–26 (FY26)? Hardly. Instead, the baseline goals were quietly lowered:

  • The Original NEP Alignment: The initial mandate for FY26 demanded 24,400 ckm of inter-regional and intra-state lines to keep pace with scheduled generation projects.
  • The Administrative Adjustment: Blaming supply chain lead times and land disputes in Western corridors, officials slashed the target by 37% down to 15,382 ckm.
  • The Surface Metric: When crews finished 12,139 ckm, state reports celebrated a comfortable 78.92% achievement rate.
  • The Structural Benchmark: Set against the true generation requirements, physical construction achieved a miserable 49.75%.

The Ministry of Power defended these edits as a pragmatic move to prioritise critical Green Energy Corridor Phase-II (GEC-II) routes over redundant capacity. But shifting paper benchmarks cannot override classical mechanics. An under-built grid chokes when overwhelmed with power, regardless of what administrative memos claim.

Historical Breakdown: Generation Expansion vs. Transmission Deployment

Look back over nine years of transmission progress against solar and wind rollouts, and the exact moment the wires fell behind generation becomes impossible to ignore.

Transmission Lines Built vs. RE Capacity Added (2017–2026)

Financial YearTransmission Target (ckm)Transmission Achieved (ckm)Solar + Wind Added (MW)Target Achievement (%)
2017–1823,08623,11911,428.92100.14%
2018–1922,64722,4378,231.9499.07%
2019–2023,62111,6648,627.8549.38%
2020–2115,79116,7507,132.10106.07%
2021–2219,25514,89513,871.0377.36%
2022–2314,58114,62515,059.35100.30%
2023–2416,68214,20318,286.6285.14%
2024–2515,2538,83027,984.1857.89%
2025–26 (Adjusted)15,38212,13950,671.0978.92%
2025–26 (Original)24,40012,13950,671.0949.75%
2026–27 (YTD July 31)16,5544,08116,376.1024.65%

Data Sources: Central Electricity Authority (CEA) Progress Reports, Ministry of New and Renewable Energy (MNRE), Sectoral Compiled Data.

The FY27 Run-Rate Reality Check

Years of compounded shortfalls have turned execution demands in 2026–27 (FY27) into an absolute crunch. Between April 1 and July 31, 2026, engineering teams completed 4,081 ckm out of an annual goal of 16,554 ckm. That leaves the YTD achievement sitting at a weak 24.65%.

The Great Transmission Delusion: Why Credit Rating Methodologies Missed India’s Systemic Grid Bottleneck - Graphic Illustration 2

A straightforward run-rate calculation lays bare the sheer logistical improbability of hitting the remaining FY27 line targets:

  1. The Remaining Target: India must complete 12,473 ckm of high-voltage circuit lines across the final eight months of this fiscal year (August 2026 through March 2027).
  2. The Required Pace: Construction crews need to deliver an unprecedented 1,559 ckm per month.
  3. Historical Context: Over the last three fiscal years, monthly build rates stagnated between 735 ckm and 1,011 ckm. Reaching the current goal requires a 54% jump above historical peak performance effective immediately.

All the while, clean power rollouts show zero signs of cooling off. In the exact same four-month window (April–July 2026), developers connected 16,376 MW of solar and wind capacity—following a historic 50,671 MW added during FY26. The power generation engine is moving at an exponential sprint; grid infrastructure is crawling linearly behind it.

Market Dynamics: Bidding Delays and Private Sector Friction

This operational divergence stems directly from structural mismatch between how generation and transmission assets are procured.

Solar and wind farms go up remarkably fast (typically 12 to 18 months) using standardized parcel leasing. In contrast, complex Inter-State Transmission System (ISTS) corridors take 36 to 48 months to build out. India’s transition to Tariff-Based Competitive Bidding (TBCB)—meant to draw capital from infrastructure giants such as Adani Energy Solutions, Sterlite Power, and Tata Power—fostered aggressive price competition, but exposed developers to severe external shocks:

  • Litigation and Bidding Stalls: Compensation wrangles and route alignment disputes under TBCB rules sparked endless court battles. Project awards ended up delayed by up to 18 months in core energy hubs like Gujarat’s Khavda RE park and Rajasthan’s Bhadla generation complex.
  • Capital Cost Squeezes: A global spike in engineering, procurement, and construction (EPC) prices squeezed tight fixed-tariff TBCB contracts awarded in early 2023. Developers sat on non-viable projects, refusing to break ground without financial relief.

Why Credit Rating Methodologies Missed Systemic Grid Risk

The frantic shift in tone from rating analysts in mid-2026 exposes a classic flaw in debt evaluation: confusing individual credit risk with broad systemic physical risk.

Rating agencies fixate on financial mechanics—capital structure, debt-service coverage ratios (DSCR), and counterparty reliability. Their analytical models worked as intended for isolated project risks, but proved completely blind to system-wide grid congestion:

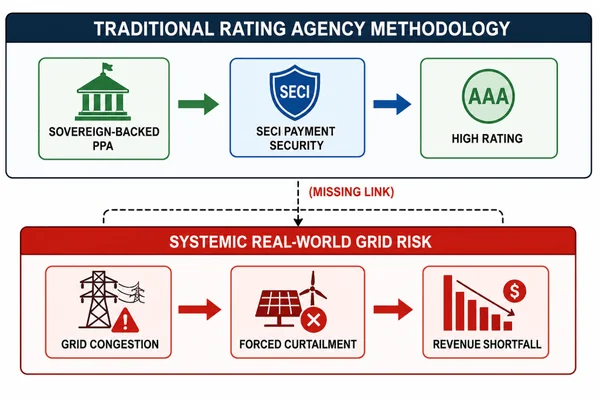

The Great Transmission Delusion: Why Credit Rating Methodologies Missed India’s Systemic Grid Bottleneck - Graphic Illustration 3
  1. Over-Reliance on Counterparty Strength: Analysts rated solar ventures on the back of sovereign-backed buyers like the Solar Energy Corporation of India (SECI). Because SECI’s payment protection schemes guarantee cash flows, individual bond issuances scored pristine ratings—even while physical access to a live substation remained a distant dream.
  2. Linear Infrastructure Blindspots: Land title disputes, environmental clearances, and right-of-way battles do not impact a balance sheet during early development phases. They hit only when a completed, expensive solar plant stands idle because the connecting line is missing.
  3. Global & Domestic Supply Chain Strain: Models failed to factor in supply chain choke points. Beyond global shortages of High-Voltage Direct Current (HVDC) kit and Extra-High Voltage (EHV) transformers, local policy compounded the lag. India’s import curbs under the Revised Trusted Sources List for power hardware successfully protected national security interests and boosted domestic factories, but severely restricted foreign transformer imports. Lead times for vital 765kV substation gear ballooned from 12 months to over 30 months.

By August 2026, these theoretical oversights have turned into painful financial realities: uncompensated power curtailments, negative price spreads during midday generation spikes, and delayed commercial operation dates.

Market Adaptations: The Surge in Storage and Hybrid Architectures

Stung by transmission bottlenecks, renewable power developers in 2026 are turning to pragmatic, site-level fixes:

  • Grid Curtailment Dynamics: Across solar-dense regions in Rajasthan and Andhra Pradesh, State Load Despatch Centres (SLDCs) regularly force developers to throttle output during afternoon hours as regional lines reach capacity.
  • The Storage Pivot (BESS & PHS): To sidestep clogged export lines, developers are combining plants with Battery Energy Storage Systems (BESS) and Pumped Hydro Storage (PHS). Storage lets assets soak up peak solar power during the day and feed it into the grid during off-peak evening hours, extracting maximum utility from limited wire capacity.
  • Stranded Asset Risk: Despite this surge in storage buildout, tens of gigawatts of completed generation capacity across Western India sit throttled, waiting on delayed multi-circuit substations to finally come online.

Summary

  • “Credit rating frameworks mispriced systemic risk by over-relying on SECI payment structures, ignoring off-grid realities like transformer lead-time spikes, linear land acquisition delays, and localized power curtailment.”
  • “Administrative target cuts throughout 2025–26 hid a severe execution slump where real line construction fell below half of actual grid requirements, masking structural deficits until mid-2026.”
  • “Hitting remaining FY27 transmission targets demands completing 1,550 ckm monthly through March 2027—a 54% leap above historical performance maximums.”
