Plugged In & Locked Out: Why India’s Clean Energy Boom Is Stalling at the Transmission Line

Plugged In & Locked Out: Why India’s Clean Energy Boom Is Stalling at the Transmission Line - Featured Cover Image

Between April and August 2026, India’s power grid hit a milestone that should’ve been cause for celebration. Clean energy and large hydro combined to produce 28.54% of the country’s total electricity. It’s a massive leap. But there’s a gritty reality hidden behind those figures. Millions of kilowatt-hours of green power are being dumped at the source. It’s a messy collision between fast-moving tech and slow-moving infrastructure.

As solar farms pop up faster than we can string wires, grid operators are stuck in a corner. They’re often forced to kill off zero-emission electrons just to keep the system from crashing.

A Five-Year Shift (2022–2026)

The electricity scene in India has changed completely since 2022. If you look at the high-demand months from April to August, you can see how fast renewables are pushing fossil fuels out of the picture.

April–August Power Generation Breakdown (2022–2026)

Plugged In & Locked Out: Why India’s Clean Energy Boom Is Stalling at the Transmission Line - Graphic Illustration 1

What the Numbers Tell Us

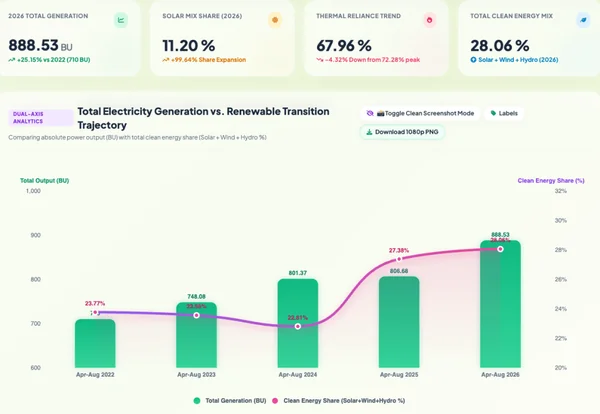

  • The Solar Surge: Solar hasn’t just grown; it’s exploded. Its share has doubled, climbing from 5.61% in 2022 to 11.20% in 2026. This happened even as the total power volume grew to 888.53 Billion Units (BU).
  • Coal’s Retreat: Fossil fuels are losing ground. Coal and gas once held a 73.38% grip in 2024, but that’s fallen to 67.96% in 2026. It turns out clean power can handle the heavy lifting during the day.
  • The Hydro Gamble: Water power is still at the mercy of the clouds. After a decent 2025, hydro output dipped to 9.00% in 2026. This makes solar and wind even more vital for keeping the lights on.

The Evacuation Bottleneck: The Curtailment Crisis

The raw numbers look great, but they hide a structural nightmare. You can build a solar park in 12 months. Building the massive high-voltage lines needed to move that power? That takes four years. You’ve got to fight for land and navigate a mountain of red tape. The result is a massive traffic jam on the grid.

Most of this trouble is happening in the West and North. In Rajasthan, the desert is covered in panels at Bhadla and Bikaner. In Gujarat, the Khavda region is pumping out massive amounts of energy. The problem is simple: they’re making more power than the local substations can swallow.

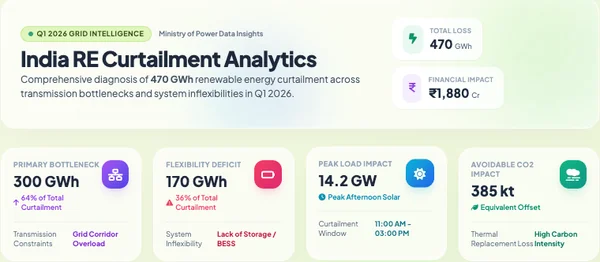

The Bottom Line: In the first three months of 2026, India wasted roughly 470 GWh of renewable energy because it had nowhere to go. 64% of that loss was down to physical blockages in the wires.

Plugged In & Locked Out: Why India’s Clean Energy Boom Is Stalling at the Transmission Line - Graphic Illustration 2

This isn’t just a technical glitch—it’s a financial hit. Developers in these crowded areas say they’re losing 1.5% to 2.0% of their potential output when the sun is at its brightest. On paper, these plants have “Must-Run” status. In reality, dispatch centres pull the plug whenever the grid gets shaky. Since there’s no real system to pay them back for that lost power, the developers just eat the loss. That makes the banks nervous.

To fix this, the Ministry of Power is trying to hurry along Phase-II of the Green Energy Corridor (GEC). They want to add 10,700 kilometres of new lines. Still, the new panels are going up faster than the workers can dig the holes for the towers.

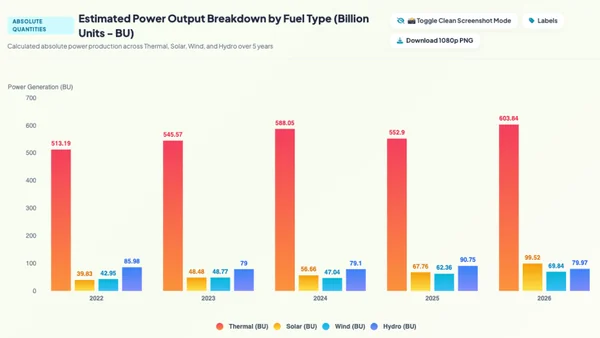

Plugged In & Locked Out: Why India’s Clean Energy Boom Is Stalling at the Transmission Line - Graphic Illustration 3

A Plan for Grid Resilience

If we don’t want these local bottlenecks to wreck the national climate goals, we have to change how we think. We can’t just keep adding capacity. We need to modernise the brain of the grid. Here’s how:

  1. Massive Battery Storage (BESS): We need big batteries at the pooling stations. They soak up the midday solar spike and spit it back out when everyone turns their lights on at night. Chile did this in 2025 and saved 2 TWh of power. India is now pushing for 47 GW of storage by 2032 to follow suit.
  2. Hard Rules on Forecasting: Regulators are getting tough. In 2026, Karnataka and its neighbours tightened the screws. If solar and wind operators can’t predict what they’ll produce with high accuracy, they get hit with immediate fines. It’s about making the unpredictable predictable.
  3. AI-Driven Dispatch: Transmission operators are finally using machine learning. These tools look at 5-minute windows to find where the grid is about to choke. By spotting these spots early, they can cut costs by up to 25% during peak hours.
  4. Fixing the Money Side: We need to move away from old, rigid contracts. If a dispatcher tells a clean energy plant to shut down for the good of the grid, that developer should get paid. It’s only fair. Market-based compensation would stop the arbitrary shut-offs we see today.

Article Summary

  • Solar Expansion: Solar’s share hit 11.20% by August 2026, helping push coal’s share down to 67.96%.
  • Grid Lag: Capacity in Rajasthan and Gujarat is growing faster than the wires can handle, wasting 470 GWh in early 2026.
  • The Fix: India must pair new lines with big batteries, AI-managed dispatching, and fair pay for developers when power is curtailed.
